HSE, Safety & Certified SiGeKo Coordination

HSE, SAFETY & SIGEKO

Certified SiGeKo Coordination for Planning and Execution

SiGeKo services are delivered by a certified coordinator, integrating safety planning, stakeholder coordination, monitoring and documentation throughout the agreed project phases.

CERTIFIED SIGEKO AND INTEGRATED SAFETY COORDINATION

Effective HSE and SiGeKo coordination begins during the planning of execution and continues as the construction programme evolves. Responsibilities, contractor interfaces, project risks, documentation and reporting requirements must be defined and continuously coordinated.

Bravo provides certified SiGeKo coordination and practical HSE support tailored to the project scope, the German Construction Site Ordinance (BaustellV), applicable RAB requirements and the specific statutory appointment agreed with the client.

HSE, Safety & Certified SiGeKo Coordination
HSE, Safety & Certified SiGeKo Coordination
HSE, Safety & Certified SiGeKo Coordination
HSE, Safety & Certified SiGeKo Coordination
HSE, Safety & Certified SiGeKo Coordination

OUR APPROACH

✓ Establish project-specific HSE and SiGeKo requirements early
✓ Coordinate safety during planning and execution phases
✓ Define responsibilities, documentation and escalation routes
✓ Align clients, contractors, designers and relevant stakeholders
✓ Use structured inspections, meetings and reporting to support improvement

SCOPE OF SERVICES

✓ Certified SiGeKo coordination during planning and execution
✓ SiGePlan preparation, maintenance and project-specific documentation
✓ Contractor coordination, safety meetings and interface reviews
✓ Site inspections, observations and corrective-action follow-up
✓ Coordination of applicable safety and health requirements

SAFETY COORDINATED ACROSS PROJECT INTERFACES

Bravo connects the agreed HSE and SiGeKo framework with the practical requirements of planning and daily site operations. Safety activities are coordinated with logistics, access, work sequencing, design decisions and contractor interfaces rather than managed as an isolated process.

Delivery may include:

  • planning and execution-phase coordination;
  • SiGePlan preparation and continuous updating;
  • site monitoring and scheduled inspections;
  • contractor coordination and safety meetings;
  • review and coordination of project safety documentation;
  • observations, corrective actions and structured reporting;
Operational OutcomeCoordinated safety responsibilities, visible risks and documented follow-up across all project interfaces.

What Your Project Gains

- Certified coordination aligned with the agreed statutory appointment
- Clear safety responsibilities and contractor interfaces
- Earlier visibility of hazards and operational risks
- Better coordination between planning, logistics and construction activities
- Consistent inspections, documentation and corrective-action follow-up
- Transparent reporting and stronger compliance readiness

DEFINE THE REQUIRED SIGEKO AND SAFETY SCOPE

Bravo can support certified SiGeKo coordination, project-specific HSE planning and clearly defined safety-management services.

Discuss the project phase, applicable requirements, statutory appointment and contractual deliverables with our team.

CERTIFIED SAFETY COORDINATION

HSE, Safety &
Certified SiGeKo

Integrated safety planning, statutory SiGeKo coordination and practical HSE controls from design preparation through execution and documented close-out.

CERTIFIEDSiGeKo competence
COORDINATEDContractor interfaces
DOCUMENTEDActions and evidence
INTEGRATEDPlanning and execution
FROM PREVENTION TO DOCUMENTED CLOSE-OUT

One integrated safety process in five clear phases

We connect statutory coordination, project HSE management and field controls in one practical delivery model.

01Assess & Define
02Plan & Structure
03Coordinate & Communicate
04Inspect & Control
05Report & Handover
HSE assessment and planning teamHazards and interfaces identified early

PHASE 01

Assess & Define

We establish the legal, contractual and operational safety basis before work starts.

  • Project scope and work phases
  • Shared hazards and interfaces
  • Applicable legal requirements
  • Roles and responsibility boundaries
Legal RegisterRisk ProfileResponsibility Matrix

OUTPUT: Defined coordination and HSE management scope.

Professional HSE and SiGePlan developmentProject-specific plans and controls

PHASE 02

Plan & Structure

We convert the assessed risks into controlled plans, procedures, registers and review routines.

  • SiGePlan under BaustellV / RAB 31
  • Project HSE Plan and objectives
  • Emergency and permit arrangements
  • Inspection and reporting schedule
SiGePlanHSE PlanControl Registers

OUTPUT: Approved, controlled project safety documentation.

Contractor coordination and toolbox talkControls understood before execution

PHASE 03

Coordinate & Communicate

Designers, contractors and logistics teams are aligned before simultaneous or high-risk activities begin.

  • RAMS interface coordination
  • Contractor safety meetings
  • Toolbox topics and evidence
  • Work area and sequence coordination
RAMS RegisterToolbox LogCoordination Minutes

OUTPUT: Clear interfaces, briefed teams and traceable decisions.

Construction HSE inspection and field controlField verification and action closure

PHASE 04

Inspect & Control

Planned controls are verified in the field, with accountable actions and evidence-based closure.

  • Scheduled inspections and tours
  • Priority action management
  • Permit and control verification
  • Escalation and closure evidence
Inspection LogAction TrackerField Evidence

OUTPUT: Verified controls and transparent action ownership.

Digital HSE dashboard reporting and handoverDecision-ready reporting and controlled close-out

PHASE 05

Report & Handover

Safety performance, open risks and document readiness are consolidated for management decisions and close-out.

  • Leading and lagging indicators
  • Weekly HSE dashboard
  • Management review and recovery
  • Safety file and final records
Weekly ReportKPI DashboardSafety File

OUTPUT: Decision-ready visibility and documented handover.

WHAT WE COORDINATE

A practical safety system for complex construction

01

Statutory SiGeKo

Coordination during planning and execution in line with the agreed appointment, BaustellV and applicable RAB requirements.

02

SiGePlan & HSE Plan

Project-specific safety arrangements, interfaces, responsibilities, procedures and control routines.

03

RAMS Coordination

Structured coordination of contractor risk assessments and method statements against project interfaces and agreed requirements.

04

Toolbox Talks

Topic planning, briefing support, attendance evidence and follow-up linked to current risks and work phases.

05

Inspections & Actions

Scheduled inspections, documented observations, owners, due dates, evidence and escalation.

06

Meetings & Reporting

Contractor coordination, safety meetings, leading indicators, action trends and decision-ready reports.

TWO COMPLEMENTARY SAFETY DELIVERABLES

We deliver both SiGePlan and Project HSE Plan

The documents have different purposes and are coordinated without blurring statutory or contractor responsibilities.

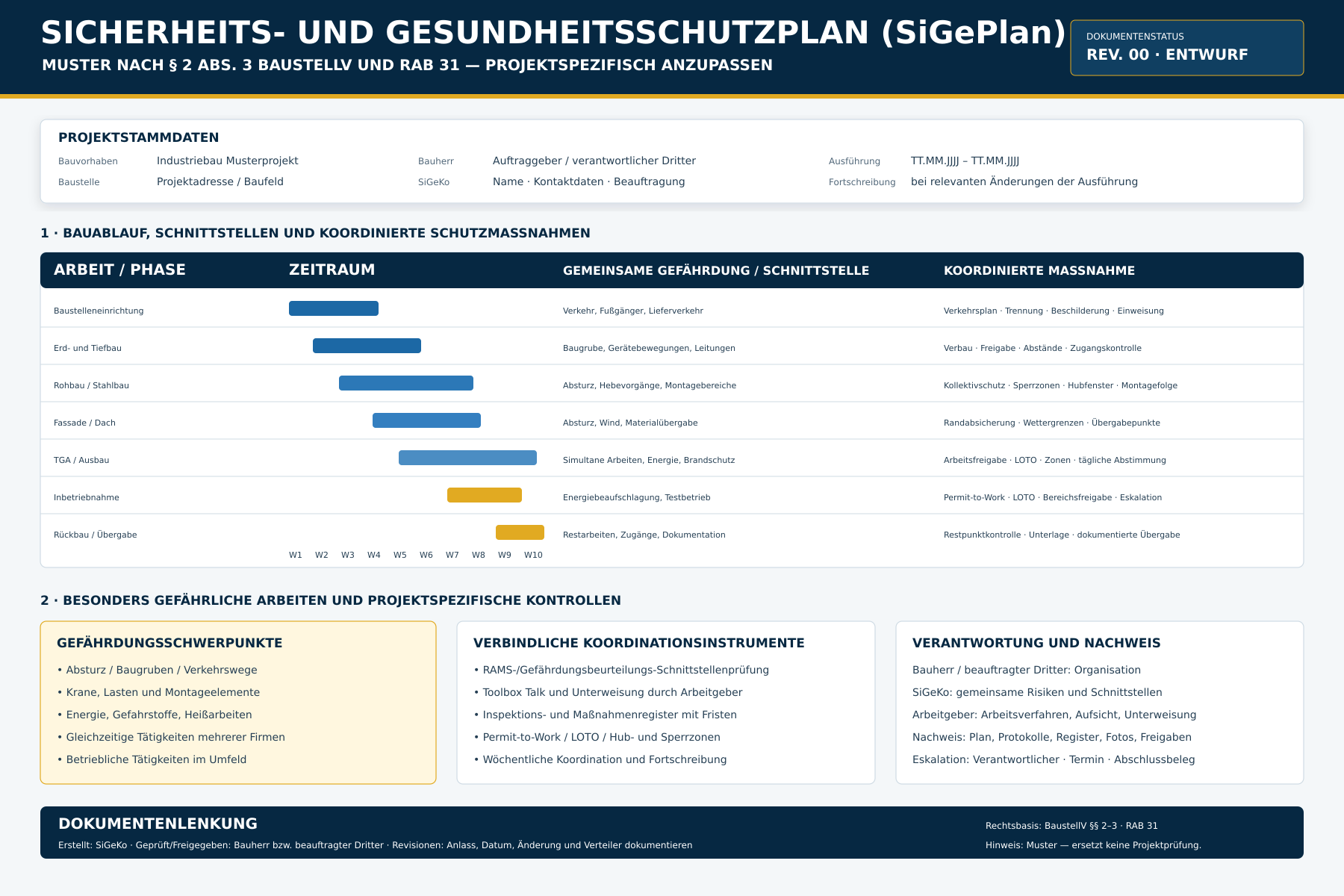

Professional German SiGePlan exampleGERMANY · BAUSTELLV / RAB 31

Safety & Health Coordination Plan — SiGePlan

Project-specific coordination of shared hazards and interfaces where § 2(3) BaustellV applies.

  • Construction sequence and simultaneous activities
  • Shared hazards and coordinated measures
  • Responsibilities, revisions and documentation

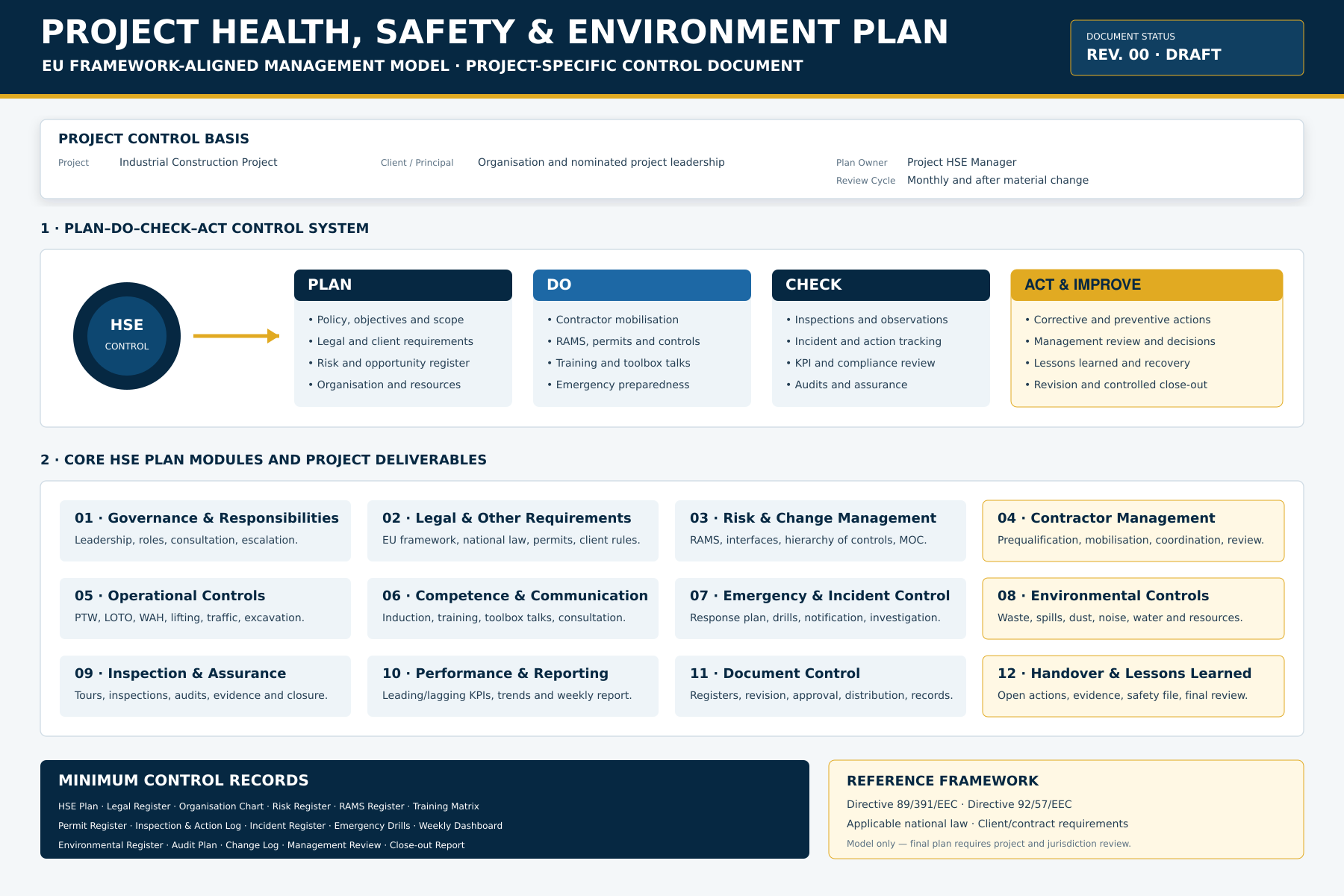

European framework aligned Project HSE Plan exampleEU FRAMEWORK · PROJECT CONTROL

Project Health, Safety & Environment Plan

The complete project HSE management system aligned with the European framework, national law and client requirements.

  • Governance, risk, contractor and operational controls
  • Emergency, environment, inspection and reporting
  • KPI review, improvement and controlled close-out
LEGAL POSITIONING: The SiGePlan is based on BaustellV and RAB 31. The Project HSE Plan is a wider management document aligned with Directives 89/391/EEC and 92/57/EEC, applicable national law and project requirements.
Contractors remain responsible for their work methods, risk assessments, instructions, supervision and statutory duties. SiGeKo coordination does not replace employer responsibility.
CORE SAFETY DOCUMENTS

Controlled documentation — from planning to close-out

Documents are maintained as active project controls, not static files.

01SiGePlanCommon hazards, coordination measures, interfaces and project updates.
02Project HSE PlanOrganisation, standards, procedures, emergency arrangements and reporting.
03RAMS RegisterSubmission, review status, interfaces, revisions and contractor ownership.
04Toolbox Talk RegisterTopics, work groups, attendance, frequency and required follow-up.
05Inspection & Action LogObservations, priorities, owners, due dates, evidence and closure.
06Meeting & Decision LogInterfaces, decisions, actions, escalation and traceability.
07Weekly HSE ReportLeading indicators, trends, inspections, actions and upcoming risks.
08Safety File / UnterlageCoordinated information relevant to later work and structured handover.
RAMS & TOOLBOX WORKFLOW

Clear order from contractor submission to field communication

The workflow connects planned work, risk controls, coordination interfaces and workforce briefing before execution.

Responsibility Boundary

Contractors remain responsible for their work methods, risk assessments, instructions, supervision and statutory duties. SiGeKo coordinates shared risks and interfaces within the agreed appointment; it does not replace contractor responsibility.

1

Work Package DefinedScope, sequence, location and interfaces
2

Contractor RAMS SubmittedRisk assessment and method statement
3

Interfaces CoordinatedShared hazards, logistics and simultaneous work
4

Toolbox Talk DeliveredWorkforce briefing and attendance record
5

Field Verification & Follow-UpObservation, evidence, action and closure
DIGITAL HSE CONTROL

A professional management view of safety performance

Inspections, actions, meetings and document status are consolidated into one transparent reporting cycle.

HSE & SiGeKo — WEEKLY CONTROLIllustrative dashboard
Planned Inspections12Current reporting cycle
Open Priority Actions7Owners assigned
RAMS In Review5Interface check active
Toolbox Talks18Attendance recorded
Priority Action Register
Work-at-height interfaceContractor ADue
Delivery route segregationLogisticsIn progress
Temporary power inspectionMEPVerified
Lifting exclusion zoneCivilsPlanned
Activity Trend
W1W2W3W4W5W6
CLIENT DELIVERABLES

Clear records, responsibilities and management visibility

SiGePlan & Update LogProject-specific coordination plan with controlled revisions.
Project HSE PlanOrganisation, procedures, roles, interfaces and reporting.
RAMS & Toolbox RegistersSubmission status, briefing records, revisions and ownership.
Inspection & Action RegisterDocumented observations, deadlines, evidence and close-out.
Weekly HSE DashboardKPIs, trends, actions, document status and upcoming risks.
Safety File & HandoverCoordinated close-out records and information for later work.
Certified coordination
Clear responsibilities
Documented follow-up
Management visibility
DISCUSS YOUR PROJECT

Define the right SiGeKo and HSE scope.

Tell us about the project phase, statutory appointment, contractor structure and required safety deliverables.

    Categories
